#108AF2

EFS Electronic Flight Strips at Schiphol TWR

Timeline

2014
2015
2016
2017
2018
2019
2020
2021
2022
2023
2024
Sep. '14CompletedDec. '19

Implementing Partners

LVNL
Leader: LVNL
Air France
Contributor: Air France
Brussels Airport
Contributor: Brussels Airport

Description

Schiphol is one of Europe’s busiest airports and the world’s eleventh busiest (2018). The Air Traffic Controllers (ATCOs) have the challenging task of coordinating 500,000 flight movements per year in a very complex layout comprising six runways. For decades, ATCOs have used paper flight strips to keep track of flights.

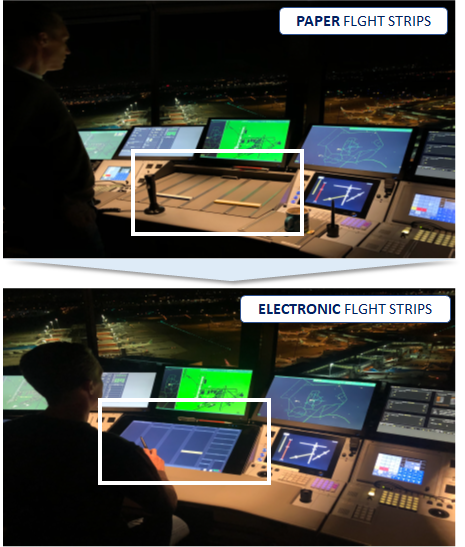

The Implementation Project #108AF2, deployed by LVNL, has allowed the upgrade of the Amsterdam Schiphol airport tower (TWR) systems thanks to the implementation of Electronic Flight Strips (EFS). Moving from paper strips to digital systems is a key step to improve the overall efficiency and safety of all tower operations.

From a technical perspective, EFS systems allow the digitalisation of pivotal data enabling real-time data updates, streamlining the entire flight-plan process, and enabling data sharing with key stakeholders such as the airport operator with the aim to enhance the collaborative decision making around surface operations (e.g. conflict management, gate/stand allocation, de-icing operations, tow management, etc.).

The #108AF2 Implementation Project key achievements can be summarised as follows:

  1. Data digitalisation, providing the foundation for further innovations, integrating and coupling the EFS system with other key operational platforms and tools being coordinated by the SESAR Deployment Manager (e.g. A-CDM, Departure Management, Safety Nets, etc.);

  2. Flexible usage of TWR working positions in which all digital data is available;

  3. A simplified, safer and more effective coordination between Air Traffic Controllers, no longer required to manually compile the strips and to verbally communicate among each other to exchange information.

The Electronic Flight Strips implementation represented a significant change in the ATCOs way to operate, hence training activities were crucial to allow a safe introduction of EFS in the operational environment. Training sessions (individual, per function and at team level) at two TWR simulators were successfully carried out involving almost 150 professionals in a 5-month timeframe.

Over a 2 months period in 2019, the air traffic controllers in the West control tower at Schiphol Airport successfully started using the EFS system before its introduction in the Central control tower.

This Implementation Project was instrumental on the wider LVNL “Tower 2.0” Programme, which encompassed the Schiphol TWR ring enlargement in order to allocate more ATCOs working positions in order to accommodate the expected growth in air traffic and airport capacity. The implementation of EFS represents one of the biggest changes in the ATC towers LVNL has ever seen.

Disclaimer

A certain number of completed projects are highlighted as it was already possible to provide detailed information on specific benefits brought by these projects. In time, SESAR Deployment Manager will provide such detailed information for every completed project.

Countries involved

Additional Information

  • Project Type: Air Navigation Service Provider
  • CEF Call Year: 2014
  • Civil/Military: Civil
  • Multistakeholder: No
  • Main AF: AF2 - Airport Integration and Throughput
  • Sub AF: S-AF 2.1 Departure Management Synchronised with Pre-departure sequencing
  • Progress Percentage: 100%
